"Critical Summary is Not Auto-Duration" Warning
-
A warning can be configured to alert you anytime there is a summary task on the critical path whose duration is not set to Auto, therefore, is longer than its subtasks.

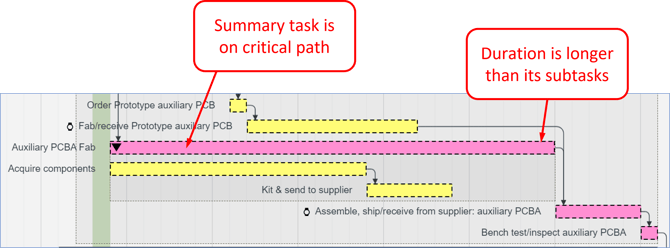

- For example, the summary task Auxiliar PCBA Fab has a duration longer than its subtasks.
/Whats%20New%20(Release%20Notes)/Apr%202023/Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%201.png?width=670&height=248&name=Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%201.png)
- A message appears in the Warnings List.
/Whats%20New%20(Release%20Notes)/Apr%202023/Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%202.png?width=550&height=333&name=Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%202.png)
- Looking at the summary's Task Properties, Auto is not checked so the duration has been manually entered (in this example 26 days) and is not determined by its subtasks.
/Whats%20New%20(Release%20Notes)/Apr%202023/Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%203.png?width=300&height=270&name=Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%203.png)
- Checking Auto forces the summary's duration to be determined by its subtasks (in this example 20 days).
/Whats%20New%20(Release%20Notes)/Apr%202023/Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%204.png?width=300&height=271&name=Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%204.png)

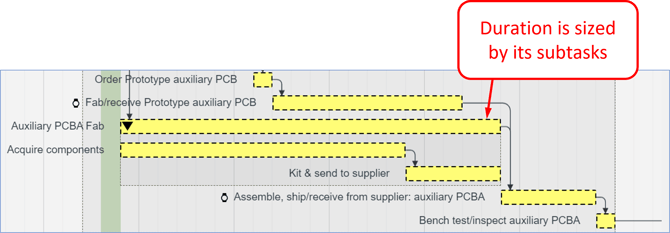

- In this example, the summary task is no longer on the critical path.
/Whats%20New%20(Release%20Notes)/Apr%202023/Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%205.png?width=670&height=234&name=Apr%202023%20-%20Critical%20Summary%20not%20auto-duration%20-%205.png)
- This warning helps to ensure that the summary task's duration isn't longer than it should be, which might incorrectly indicate a delay.
